Road and Trail Construction
Current Projects
State Road 32 Reconstruction
- Schedule: Ongoing, substantial completion in Fall 2026
- Details: Click Here
Old 146th Street & Towne Road Roundabout
- Phase I completed in Fall 2025, Phase 2 will begin in Spring 2026
- Duration – 45 days
- Detour – 146th Street, Ditch Road, 151st Street
- Contractor – Midwest Paving
- Cost – Estimated $3,000,000
161st Street Trail (Oak Road to Carey Road)
- Start Date – Fall 2025, will resume Spring 2026
- Duration – Approximately 30 days remaining
- Detour – No Closure
- Contractor – E&B Paving
- Cost – Estimated $250,000

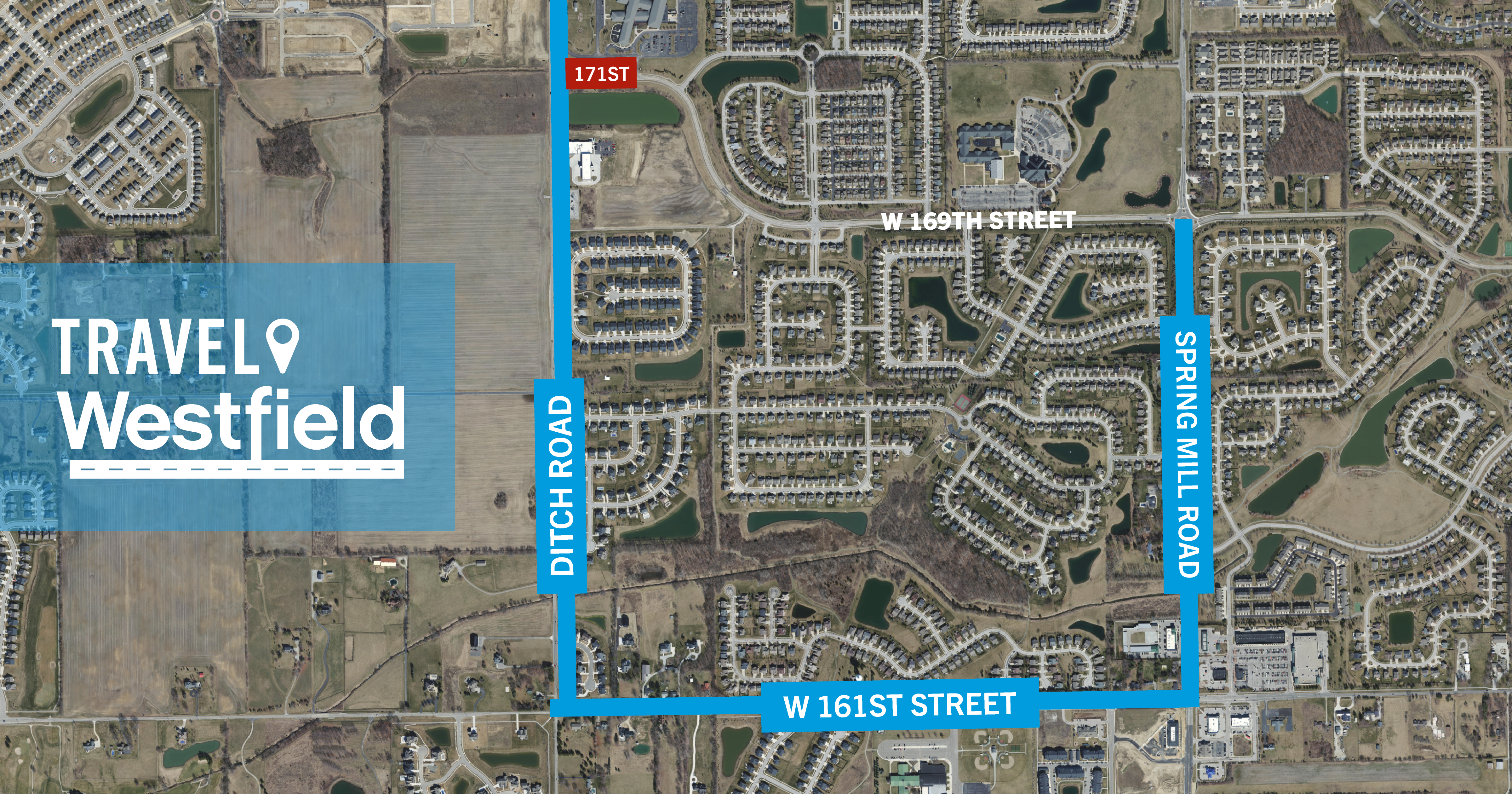

171st Street & Ditch Road Roundabout
- Started September 2025, will resume Spring 2026
- Duration – Approximately two weeks of remaining work
- Detour – Spring Mill, 161st Street, Ditch Road
- Contractor – Valenti Held
- Cost – $1,400,000
Future Projects
Monon Tunnel
- Start date – Spring 2026
- Duration – Expected Completion December 2026
- Detour – 161st Open to traffic, Monon Detour – 156th, Oak Ridge Road, 169th Street
- Contractor – TBD
- Cost – Estimated $8,000,000
191st Street Widening Phase I
Details: Widening of 191st Street from Tomlinson Road to Grand Park Boulevard, including a roundabout at Grand Park Boulevard and a pedestrian bridge for Monon over 191st.
- Schedule: Utility Work Spring 2026, Roundabout Construction Fall 2026, Remaining Construction on 191st Street and Pedestrian Bridge Construction in Spring 2027
- Design Firm: Lochmueller Group
- Contractor: TBD
- Estimated Project Cost: $15,500,000
Downtown Drainage Improvements
Details: Roads include Union, Cherry, and Roosevelt Streets and College Avenue
- Schedule: Utility Work in 2026, Construction in 2026-2027
- Design Firm: VS Engineers
- Contractor: TBD
- Total Estimated Project Cost: $3,000,000
- Funded by ARPA
Westfield Boulevard Phase II
Details: Connection from Lantern Commons to David Brown Drive including a roundabout at David Brown Drive
- Schedule: Roundabout Construction in Fall 2026, Roadway Construction on Westfield Boulevard in Spring 2027
- Design Firm: WSP
- Contractor: TBD
- Total Estimated Project Cost: $6,300,000
181st Street & Grand Park Boulevard Roundabout
- Start Date – April 4, 2026
- Opening Date – June 4, 2026
- Design Firm: DLZ
- Contractor: TBD
- Total Estimated Project Cost: $2,000,000
- Final Completion – September 2026
Mule Barn Road Widening
- Start Date – Summer 2026
- Design Firm - BF&S
- Contractor – TBD
- Detour – TBD
- Cost – Estimated $2,000,000
151st Street Trail (Oak Road to Bridlewood Subdivision)
- Start Date – Summer 2026
- Duration – TBD
- Detour – TBD
- Contractor – TBD
- Cost – Estimated $900,000
Penn Street Extension
- Start Date – August 1, 2026
- Duration – 60 Days
- Contractor – E&B Paving
- Total Estimated Project Cost – $650,000
Grand Park Boulevard & Tournament Trail Traffic Signal
- Start Date – Spring/Summer 2026
- Duration – 30 days
- Contractor – TBD
- Total Estimated Project Cost – $400,000
Grand Park Boulevard & John Dippel Boulevard Roundabout
- Estimated Start Date – Spring 2027
- Duration – TBD
- Design Firm – VS Engineering
- Contractor – TBD
- Total Estimated Project Cost – $2.2m
151st Street Raised Crosswalk (151st Street & American Lotus Drive)
- Estimated Start Date – Spring 2026
- Duration – Two Weeks
- Detour – Ditch Road, 146th Street, Towne Road
2026 Resurfacing Program
- Estimated Start Date – April 2026
- Completion – September 2026
- Contractor – TBD
- Total Estimated Project Cost – $3,000,000
2026 Concrete Patching Program
- Estimated Start Date – March 2026
- Completion – June 2026
- Contractor – TBD
- Total Estimated Project Cost – $300,000
Capital Improvement Plan
The Capital Improvement Plan is a working document through 2032 to outline infrastructure improvement projects.
View the Capital Improvement Plan here
Completed Projects
161st Street & Spring Mill Road Roundabout (includes pedestrian bridge over John Edwards Drain)
- Start Date – Approximately April 25, 2025
- Duration – 60 days (full closure)
- Detour – 156th St, Oak Ridge Road or Ditch Road, 169th/171st Street
- Contractor – Morphey Construction
- Cost – $3,590,000.00
- Final Completion - September 10, 2025
151st Street & Towne Road Roundabout
- Start Date – No later than April 7, 2025
- Duration – 80 days (full closure)
- Detour – 146th Street, Ditch Road, 156th St
- Contractor – Midwest Paving
- Cost – $1,983,669.69
- Final Completion - September 30, 2025
181st Street & Wheeler Road Roundabout
- Start Date – No earlier than May 27, 2025
- Duration – 45 days (full closure)
- Detour – 186th Street, Grand Park Boulevard, SR 32
- Contractor – Calumet
- Cost – $1,386,000.00
- Substantial Completion - October 3, 2025
- Final Completion - June 4, 2026
2025 Concrete Patching (Bridlewood Subdivision)
- Start Date – between Mid-March and Mid-April
- Duration – Completed by May 30th
- Detour – No closure
- Contractor – Midwest Paving
- Cost – $145,812.27
Updated 09/14/2025
-
Michael Pearce
Director of EngineeringPhone: 317-473-2917
